City Rail Link

City Rail Link (CRL) construction methods

Construction methods

There are two main construction methods proposed for the City Rail Link:

  1. Cut and cover where the tunnels are dug from the surface

  2. Tunnelling using a Tunnel Boring Machine (TBM), which travels at some depth below the ground and significantly reduces impact.

These will be used in different areas:

  • Cut and cover near Mt Eden station where the underground tunnels need to rise to the surface to meet the existing Western line
  • Cut and cover along Albert Street where it is likely to be too shallow for a TBM and there are utilities running down its length
  • Tunnelling by TBM from Mayoral Drive to an area beyond Symonds Street between New North and Mount Eden Roads.
ALBERT: The Albert Street cut and cover tunnel

ALBERT: The Albert Street cut and cover tunnel

The main construction area will be at the southern end of the project adjacent to New North Road. The tunnel will be bored from this end to Mayoral Drive, the equipment dismantled and returned to the start for the second tunnel bore. Spoil from the tunnels will be removed from the Eden Terrace end.

There will be smaller localised construction yard areas at Downtown and near the stations.

Cut-and-cover is a method of civil engineered construction for shallow tunnels where a trench is excavated and roofed over with an overhead support system strong enough to carry the load of what is to be built above the tunnel.

There are two basic forms of cut-and-cover tunnelling - the Top-down or Bottom-up method.

The CRL tunnels will be constructed using the bottom-up method where a trench is excavated and the tunnel is constructed through it, then carefully back-filled and the surface reinstated.

Valerie and Gomer

Both are machines that have played key parts in the early stages of the City Rail Link construction.

Pipe jacking is a trenchless construction method used to install pipelines beneath highways, railroads, harbours, rivers, and environmentally sensitive areas. Generally, pipe jacking involves a micro tunnel boring machine (MTBM) travelling from a launching shaft to a reception shaft.

CRL used the pipe jacking method to create a new stormwater main along the eastern side of Albert Street, between Swanson and Wellesley Streets with caisson shafts to be constructed at Wellesley and Swanson Street intersections. Two additional shafts were constructed in Victoria Street to enable strengthening of the Orakei Sewer Main across Albert Street.

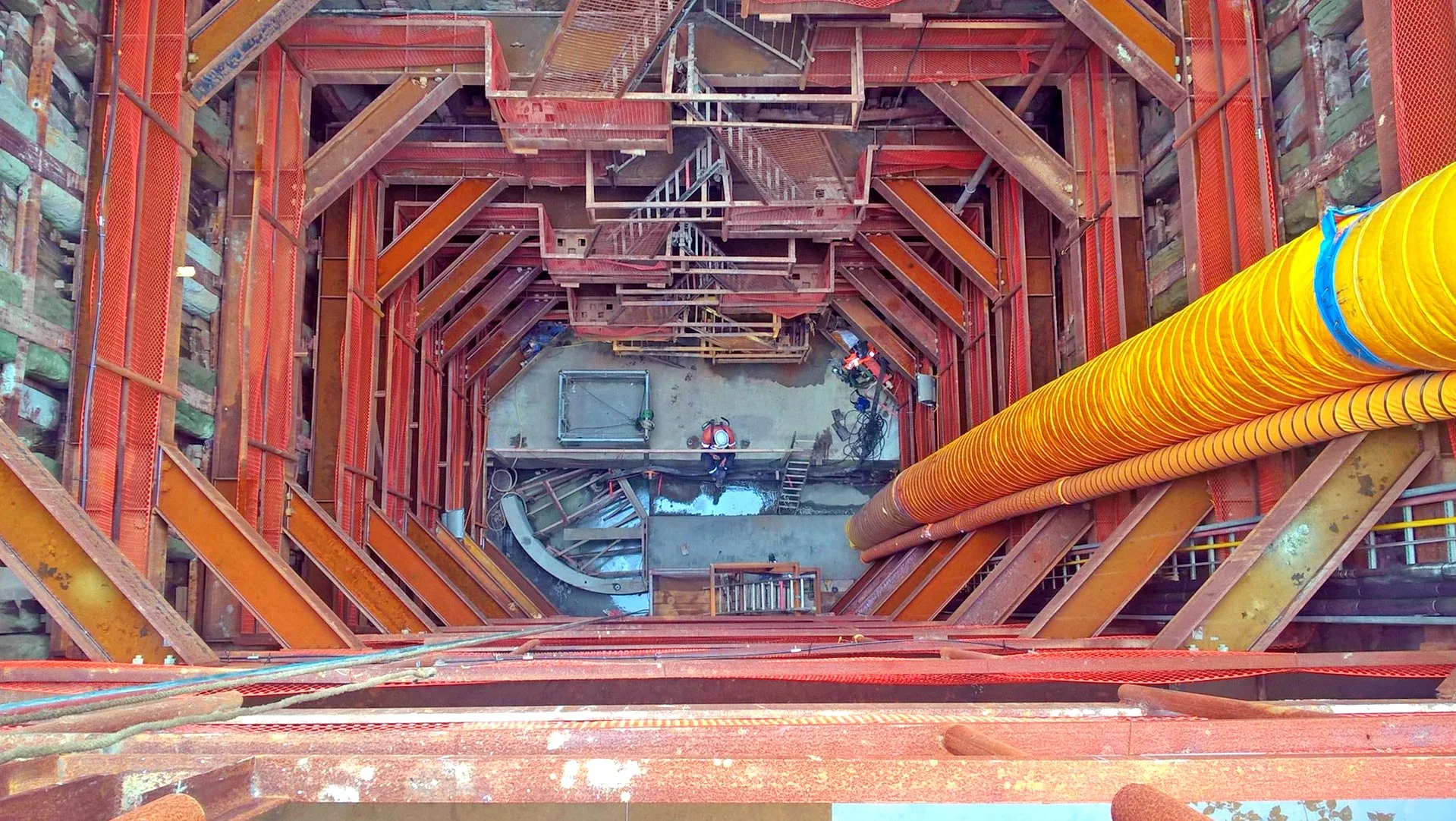

Victoria St shaft

Victoria St shaft

Traditiional pile driving rigs are usually composed of a tall framework in which either a weight is raised and dropped on a pile head or in which a steam hammer drives the pile.

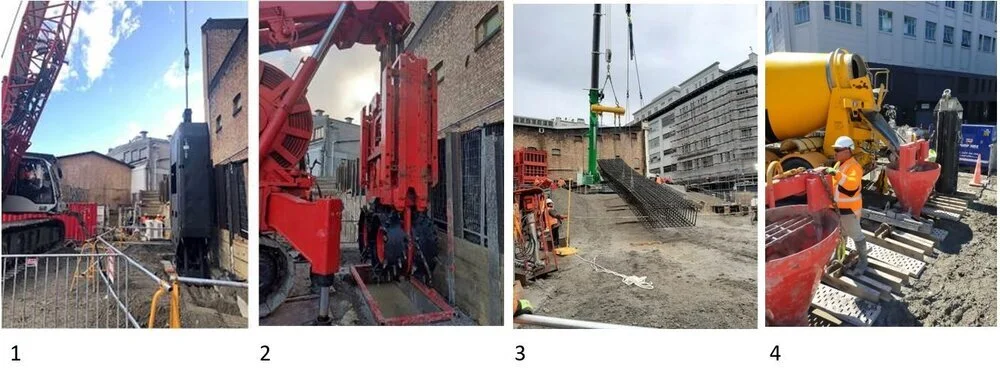

However CRL has utilised a Cased Continuous Flight Auger piling rig which does not require a weight to be dropped. This technique is quieter and has less vibration compared to traditional piling. Also the cased nature provides improved ground support during piling.

^ back to top

Valerie

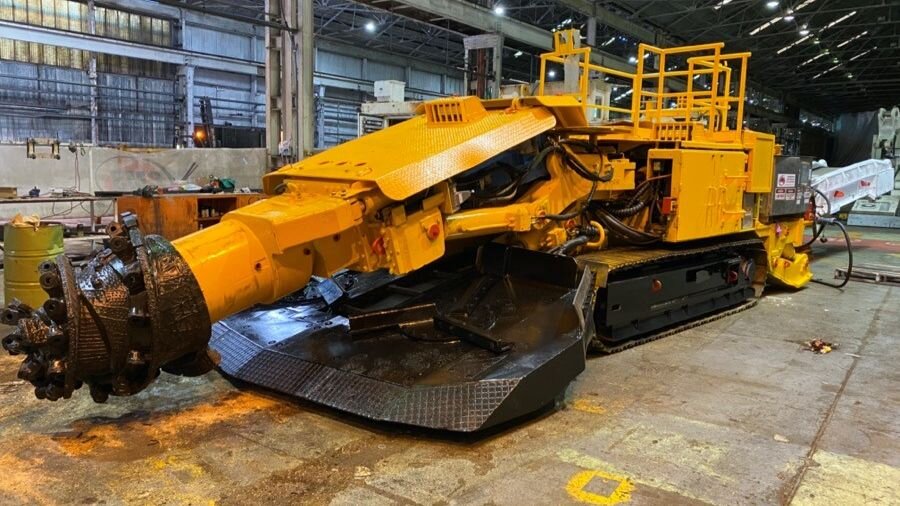

'Valerie’, was the 2m-wide tunnel-boring machine simultaneously excavating and installing a new stormwater pipe under Albert Street.

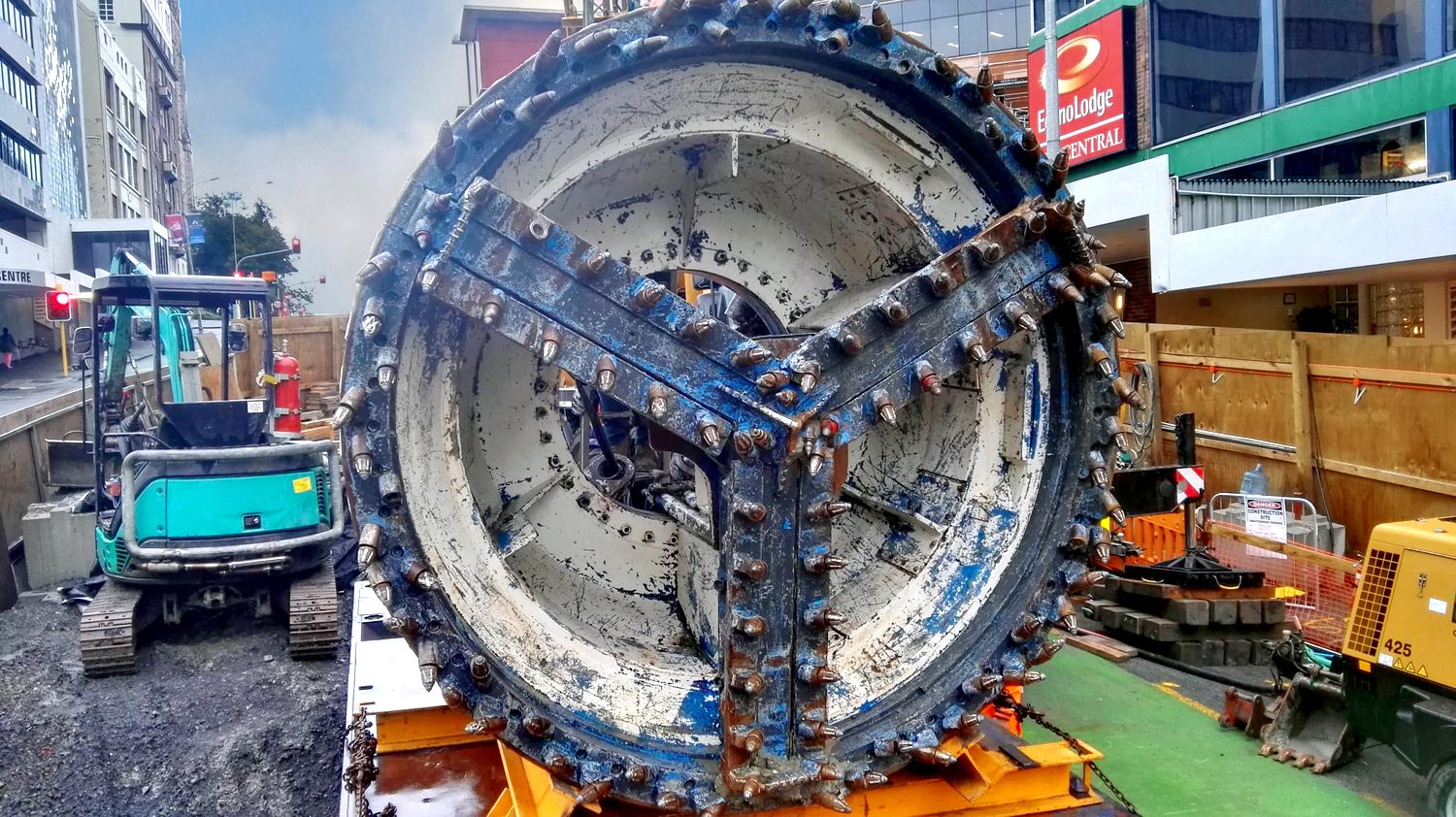

The tunnel boring machine (TBM) also known as a "mole" excavates tunnels with a circular cross section through a variety of soil and rock strata. TBMs are able to bore through anything from hard rock to sand.

MICROTUNNEL BORING MACHINE: Valerie being lowered into the Vic 1 shaft ready for commissioning in December 2016

MICROTUNNEL BORING MACHINE: Valerie being lowered into the Vic 1 shaft ready for commissioning in December 2016

Tunnel diameters can range from a metre (micro-TBMs) to around 19m.

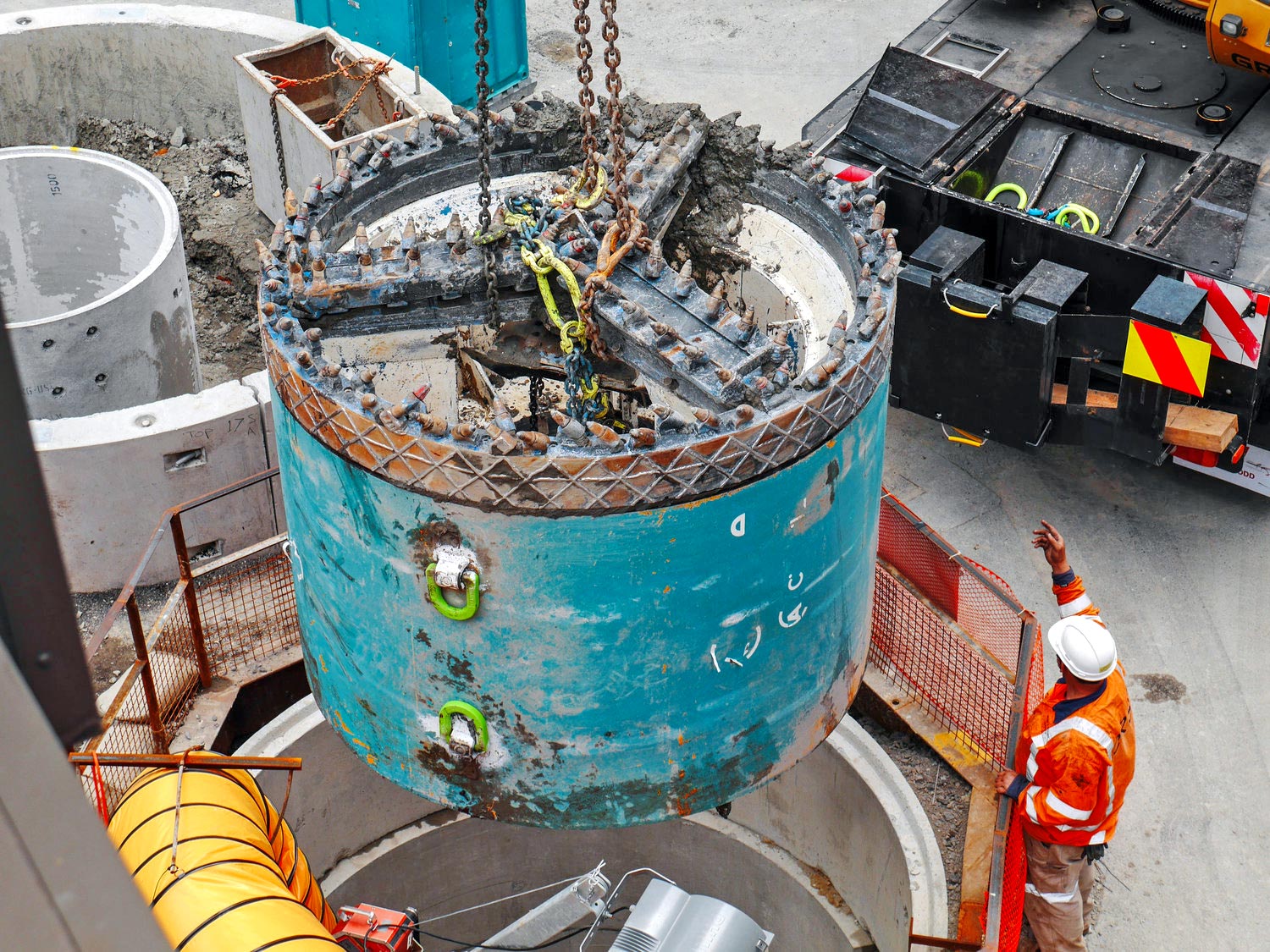

Valerie was named as such by school children in a contest in praise of the mighty Olympic shot-putter Dame Valerie Adams. It started tunnelling and pipe-jacking work from the Victoria Street on 21 November 2015. By the time she arrived at the Swanson Street reception shaft early 2017, she had travelled 290m.

Valerie was returned to the launching shaft and travelled another 200m in the opposite direction - 490m in total.

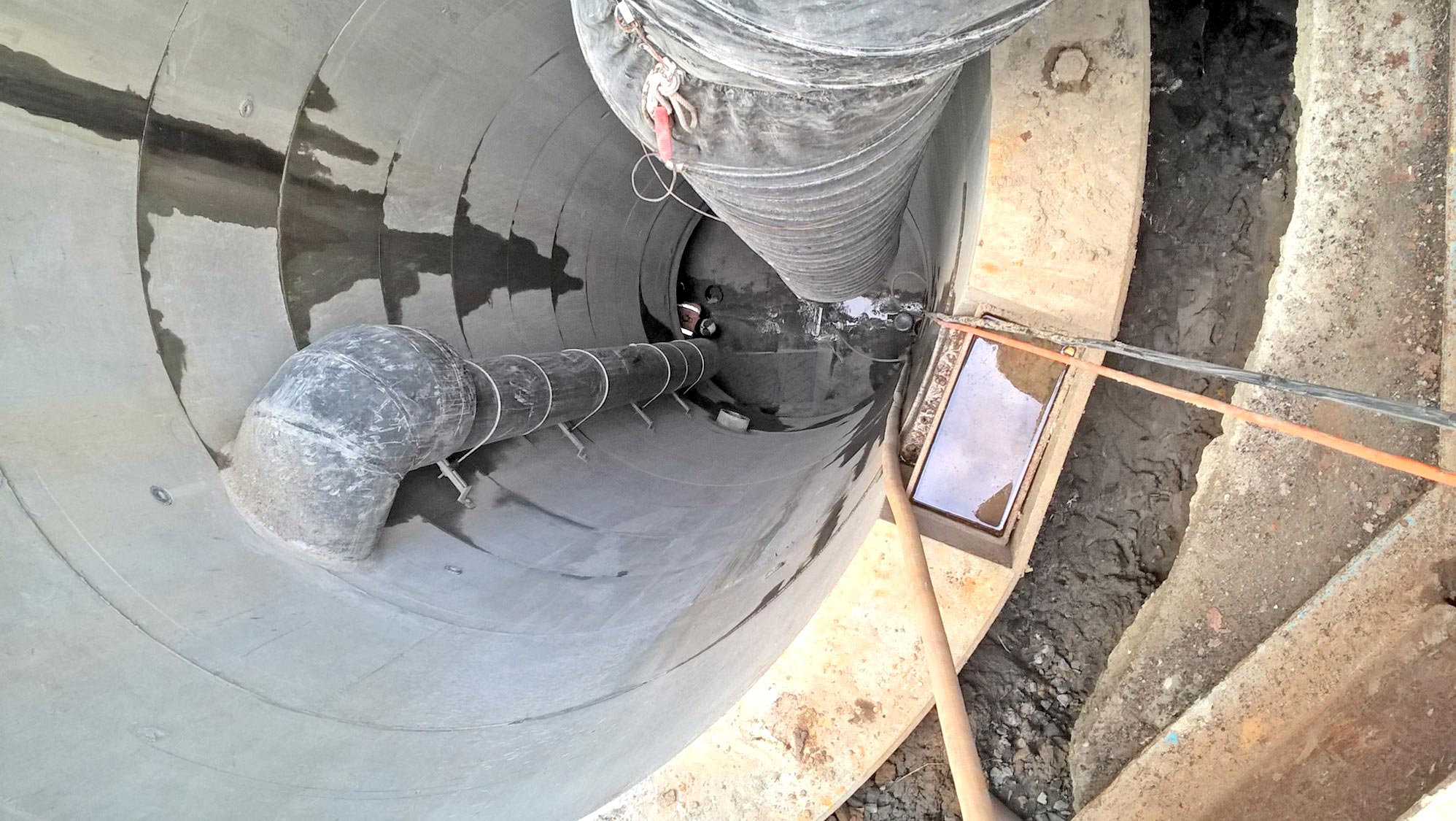

Swanson shaft

Swanson shaft

Tunnelling by a much bigger TBM is required to construct the CRL rail tunnels from Mayoral Drive to an area beyond Symonds Street between New North and Mount Eden Roads.

It is proposed that a 7m diameter TBM will be used to bore from the location of the Mt Eden Station to Mayoral Drive (Aotea), then transported back to that site to bore a second tunnel from the Mt Eden Station to Aotea.

In late April 2017, Valerie was pulled out of the Victoria Street shaft after finishing the stormwater work.

Gomer

‘Gomer’ is a nine-storey-high piling rig used on Albert St. It was affectionately named after 1960s TV character Gomer Pyle

In all Gomer dug 372 piles of up to 20m deep.

Other construction aspects

Bentonite

Sodium Bentonite is an absorbent clay that expands when wet. In civil engineering applications bentonite is used as a mineral hydraulic barrier in diaphragm walls, foundations, tunnelling, horizontal directional drilling and pipe jacking.

Bentonite slurry walls (also known as diaphragm walls) are used in construction, where the slurry wall is a trench filled with a thick mixture of bentonite and water. A trench that would otherwise collapse due to the hydraulic pressure in the surrounding soil is prevented from collapsing as the bentonite slurry balances the hydraulic pressure. Forms for concrete, and rebar, can be assembled in a slurry-filled trench, and then have concrete poured into the form. The dense liquid concrete displaces the less-dense bentonite slurry and causes the latter to overflow from the trench. The displaced bentonite slurry is then channeled to a recycling unit from which it can subsequently be reused in a new trench elsewhere on the construction site.

Two bentonite recycling units were established within the Lower Queen Street area to aid with construction of diaphragm walls through the old Downtown Shopping Centre site. Diaphragm walls will also be used for ground support and for propping when tunnels are constructed beneath the CPO building.

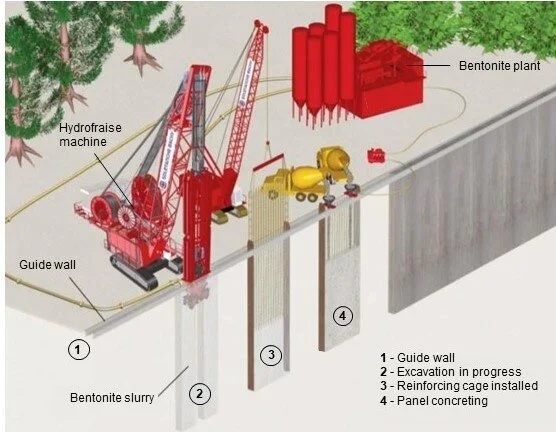

HYDROFRAISE: This hydrofraise machine will be used to dig the wall panels which form the structural support for the tunnels. This machine will use the bentonite plant to dig down about 15 metres

HYDROFRAISE: This hydrofraise machine will be used to dig the wall panels which form the structural support for the tunnels. This machine will use the bentonite plant to dig down about 15 metres

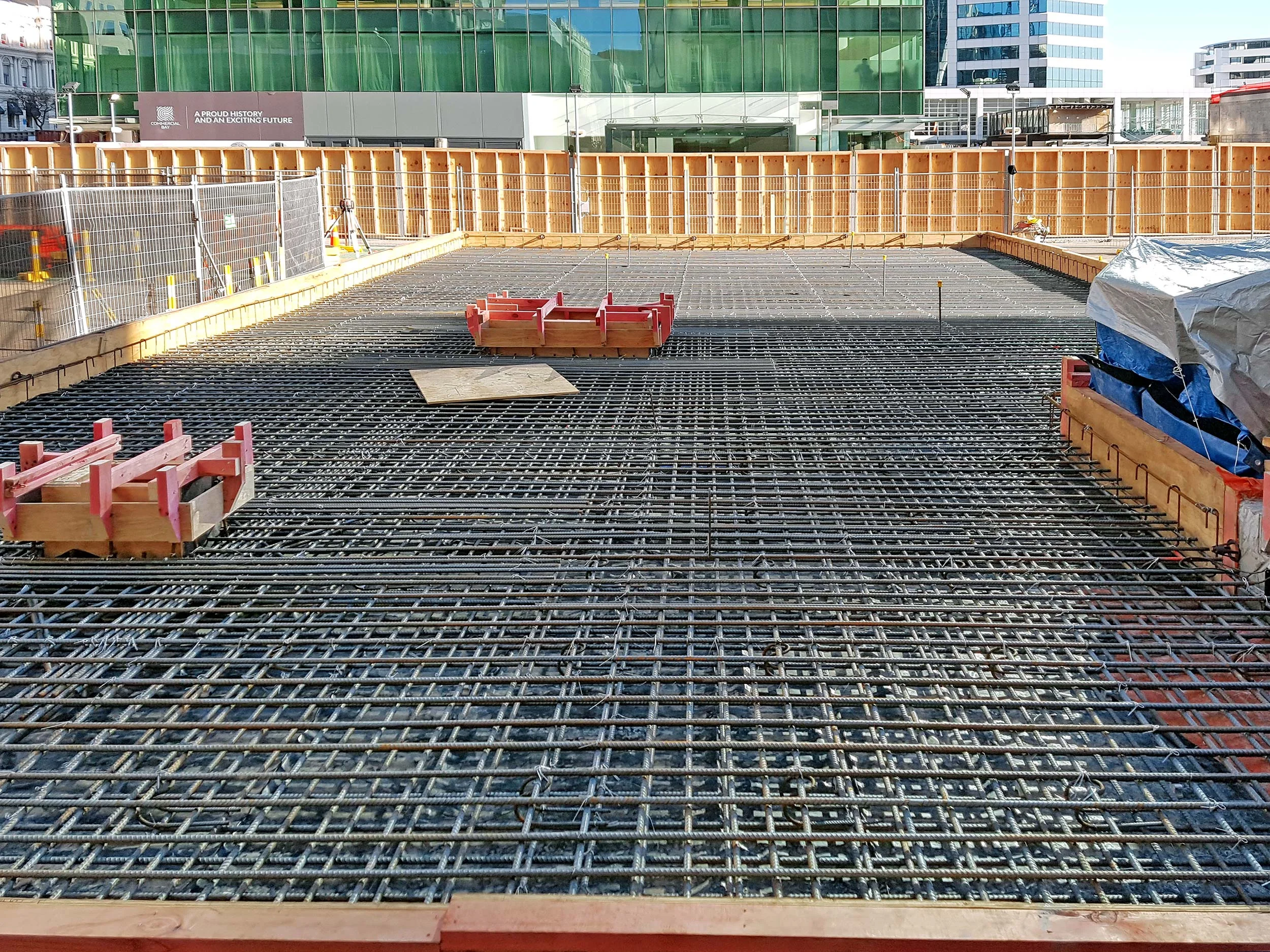

JUNE 2017- Bentonite plant foundation slab prior to a 240m^3 concrete pour.

JUNE 2017- Bentonite plant foundation slab prior to a 240m^3 concrete pour.

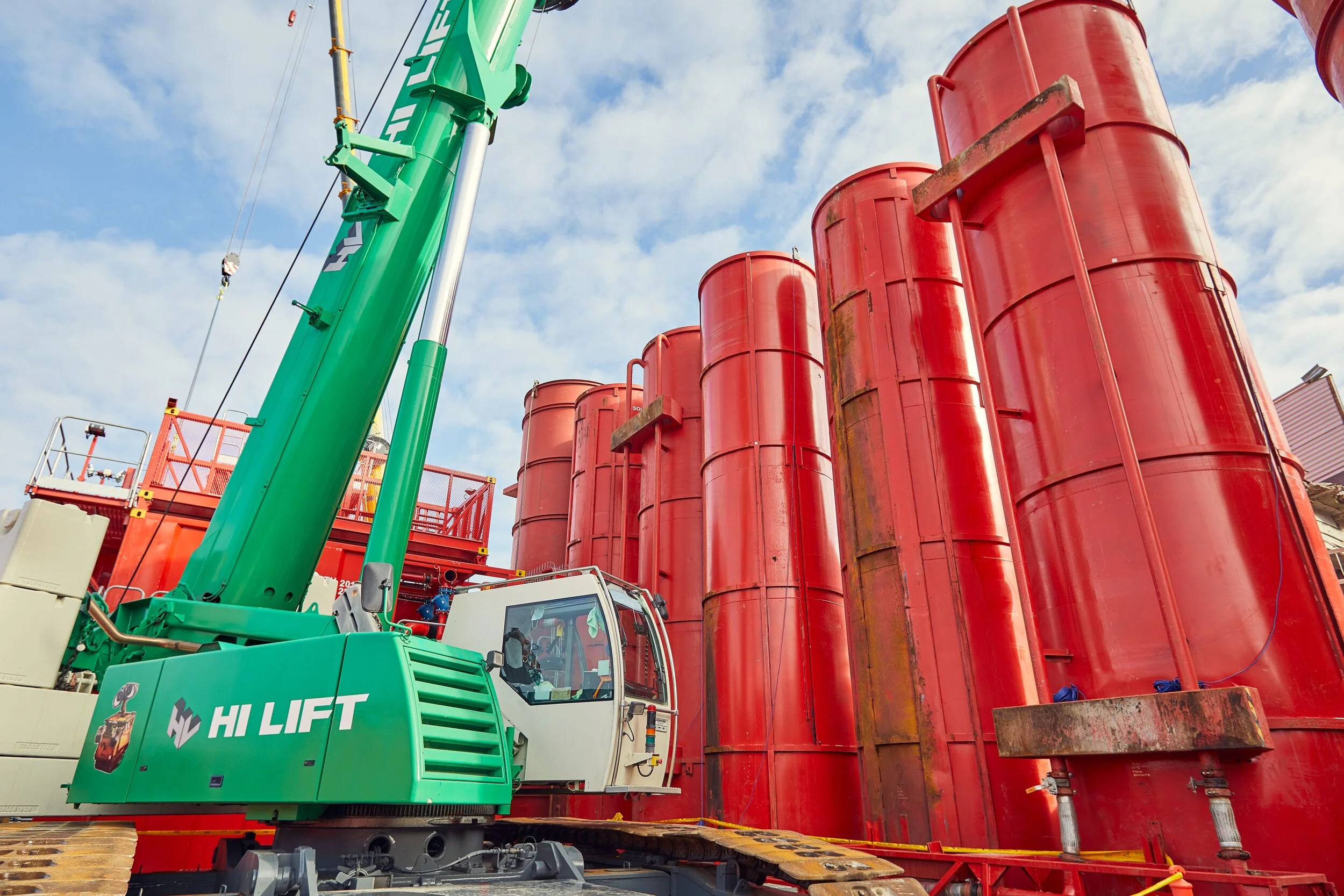

SILOS: Outside Britomart June 2017

SILOS: Outside Britomart June 2017

BENTONITE: Bentonite will be utilised while digging the structural support for the tunnel walls to ensure the excavation doesn’t cave in on itself.

BENTONITE: Bentonite will be utilised while digging the structural support for the tunnel walls to ensure the excavation doesn’t cave in on itself.

Diaphragm Wall

A diaphragm wall (or D-Wall) is a continuous wall constructed in the ground and typically to form an underground barrier or structure. Diaphragm walls are constructed through a narrow trench, excavated in ground and supported by an engineered fluid (typically a sodium bentonite mud) which is later replaced by a permanent material (concrete).

A diaphragm wall would typically be constructed as a ‘perimeter’ to prevent water ingress, for example.

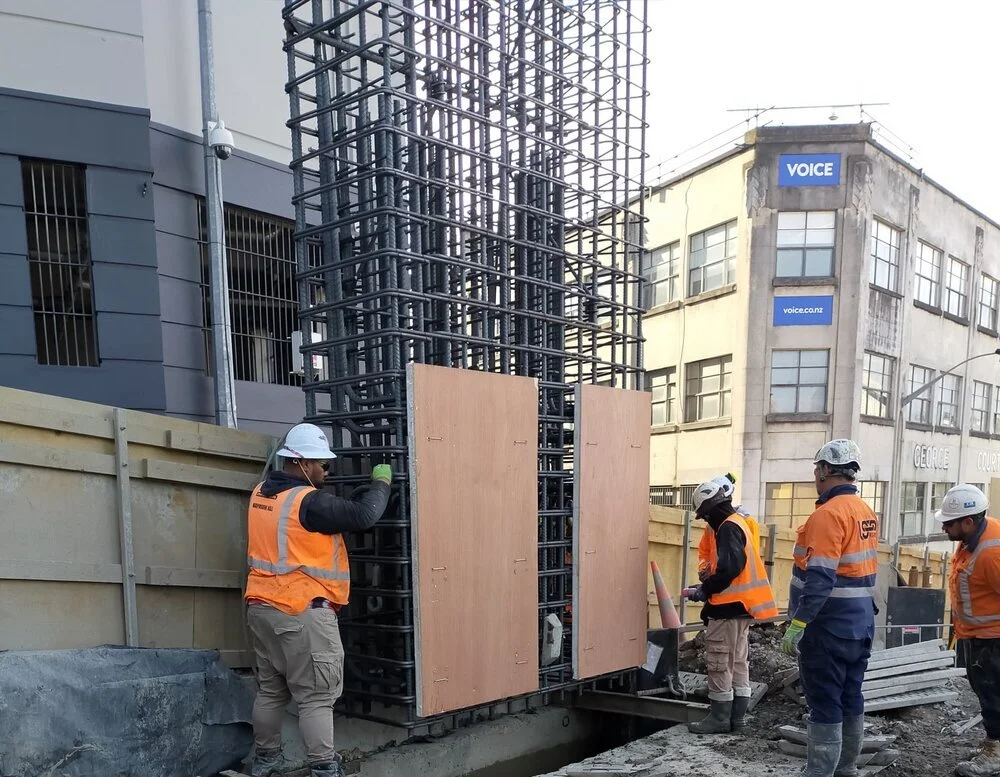

DIAPHRAGM: Constructing a diaphragm wall with steel reinforced cage - Commercial Bay

DIAPHRAGM: Constructing a diaphragm wall with steel reinforced cage - Commercial Bay

WALLS: Diaphragm walls in cut and cover tunnel construction

WALLS: Diaphragm walls in cut and cover tunnel construction

Diaphragm walls are created under Lower Queen Street from the CPO Building to enable CRL tunnels to be formed. This work is being done by Precinct Properties.

^ back to top

Caisson

A caisson is a watertight retaining structure.

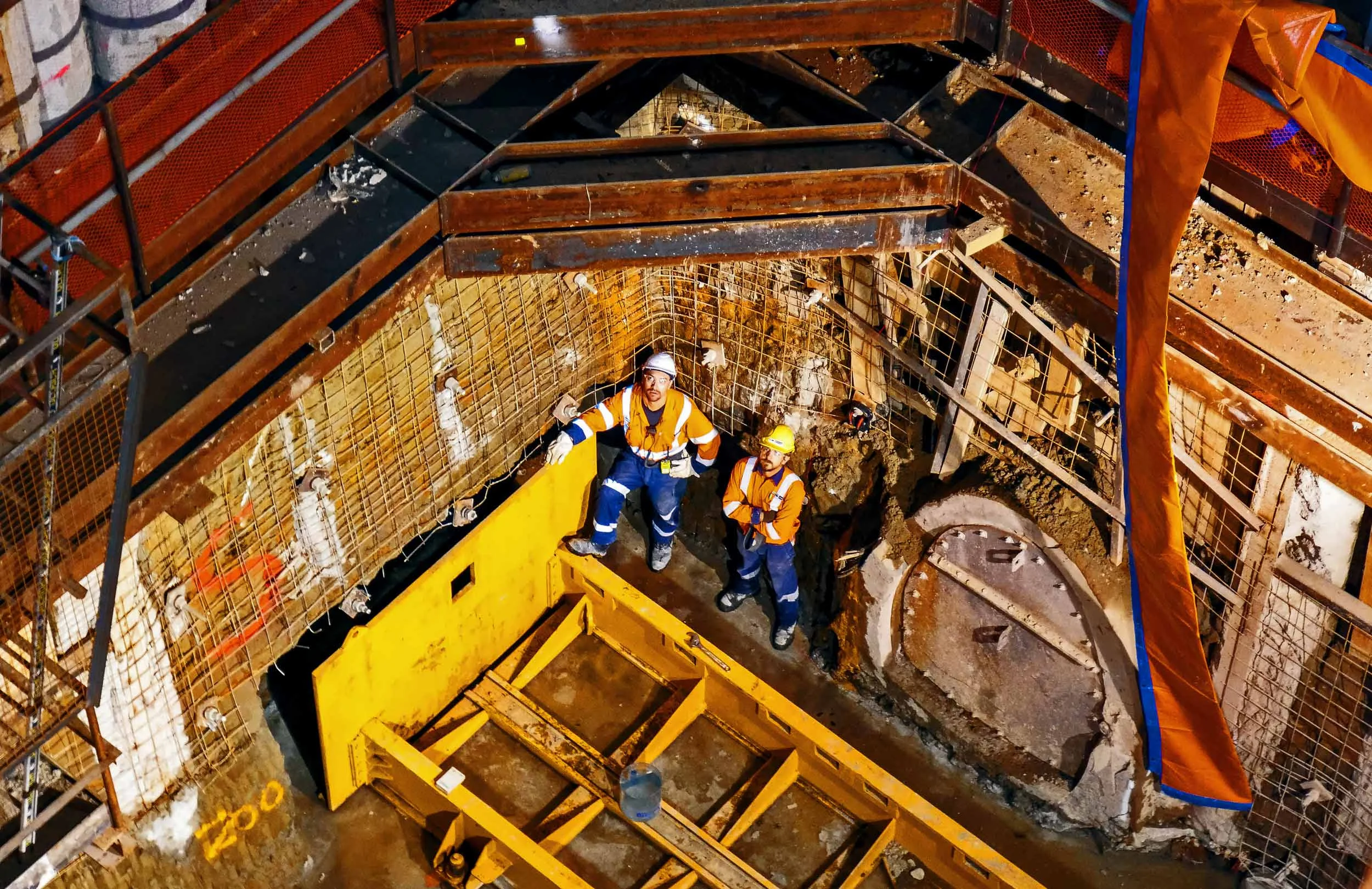

It can be used for, say, the purpose of gaining access to an existing underground service but in the case of the CRL, it's for forming reception shafts for the pipe jack works along Albert Street and at the points of connection between the new line and existing lines.

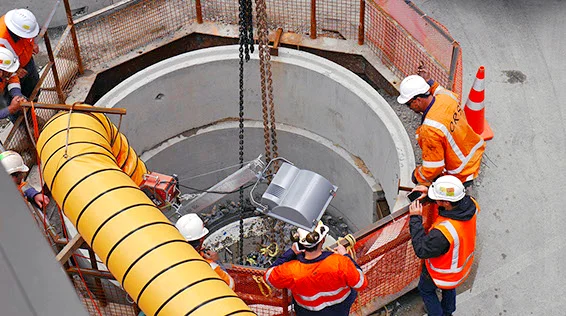

SWANSON: Segmented caisson shaft at Swanson Street

SWANSON: Segmented caisson shaft at Swanson Street

Segmented caissons are formed to create permanent portal entries to enable the Microtunnel Boring Machine (MTBM) to bore new stormwater pipes.

There are caisson shafts at Wellesley Street and a second shaft at Swanson Street.

SHAFT: A caisson shaft

SHAFT: A caisson shaft

CAISSON: Segmented caisson similar to the Wellesley and Swanson Street pipejack shafts

CAISSON: Segmented caisson similar to the Wellesley and Swanson Street pipejack shafts

Secant Pile Walls

Secant pile walls are drilled piles constructed in such a way that the piles overlap each other to form a wall. This is done to find drilling soft piles in hit and miss sequence and then drilling hard piles to interlock with the soft piles.

Secant piles are used to build cut-off walls for the control of groundwater inflow and to minimise ground movement.

^ back to top

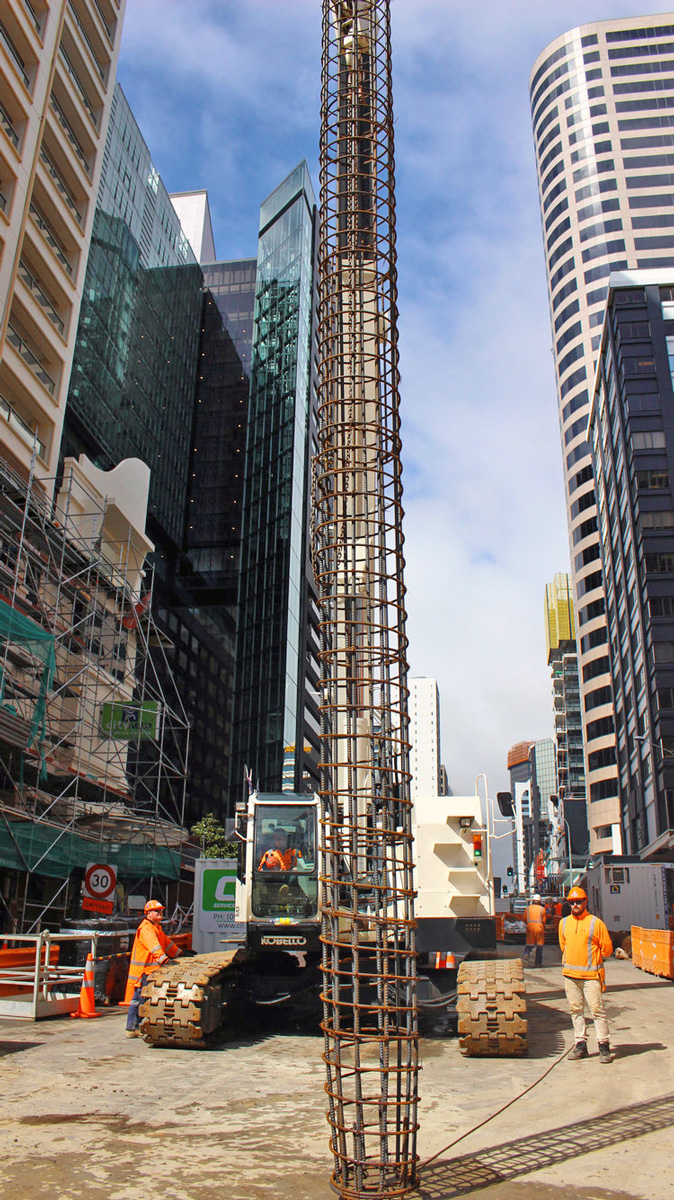

Soldier piling

Soldier piled walls are effective as a temporary means of retaining the sides of bulk excavations and will form the retaining structure along Albert Street to enable construction of cut and cover tunnels.

Soldier piling is also used to construct two deep access shafts at the Victoria and Albert Street intersections to create a cavern to enable the Orakei Main Sewer to be bridged and strengthened.

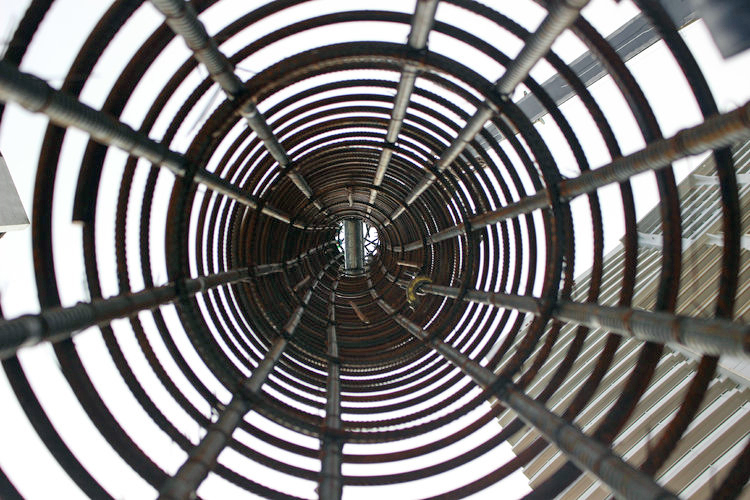

Soldier piles are constructed of wide flange steel H sections spaced at intervals of 2 to 3m apart, driven in prior to excavation.

As excavation proceeds, horizontal timber sheeting (lagging) is inserted behind the H pile flanges.

H BEAMS: Wide flange steel H Beams

H BEAMS: Wide flange steel H Beams

SOLDERING ON: Soldier piling for the OMS shaft at 'Victoria 2' - Victoria Street

SOLDERING ON: Soldier piling for the OMS shaft at 'Victoria 2' - Victoria Street

Utility Diversions

In order to clear the way for CRL construction to commence, the diversions of many essential utilities is required. This includes stormwater, water, and wastewater pipes, electricity cables, telecommunications cables, gas pipes, and any other service conduit that needs to be safely relocated for the benefit of the service providers and their customers.

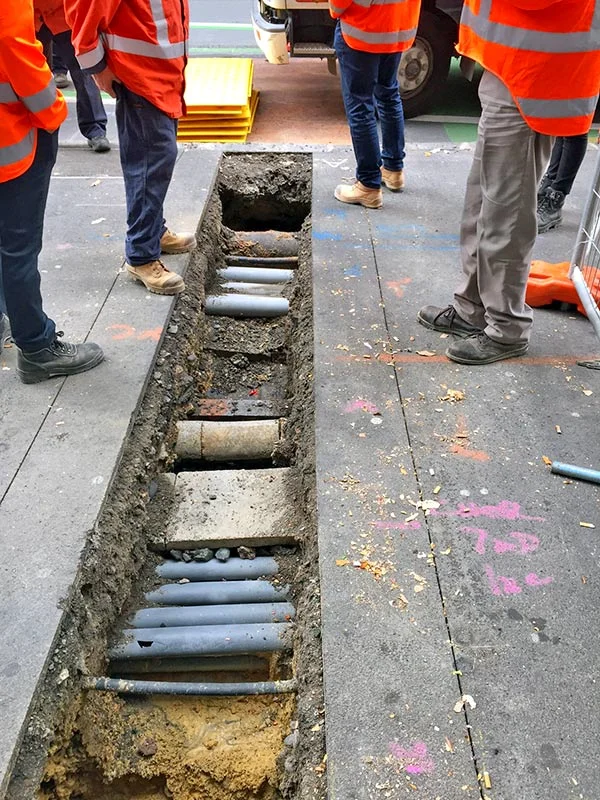

MYSTERY HUNT: Potholes are dug in streets such as here in Albert Street to find out what utilities are beneath the surface. Existing As-built records can be notoriously inaccurate and/or vague especially if those records are decades old, so identifying the owners of the utilities can be quite a task if the utilities are found to be not where the records say they should be!

MYSTERY HUNT: Potholes are dug in streets such as here in Albert Street to find out what utilities are beneath the surface. Existing As-built records can be notoriously inaccurate and/or vague especially if those records are decades old, so identifying the owners of the utilities can be quite a task if the utilities are found to be not where the records say they should be!

Here is an example of the challenge. This is a patch of Customs Street.

And here is the map of what they found underneath...

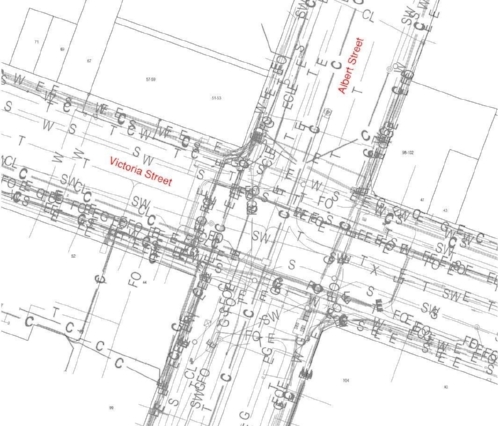

And here is a map of the utilities we've discovered n the corner of Albert and Victoria Streets

Utilities Albert and Victoria.jpg
